gray Posted February 16, 2023 Share Posted February 16, 2023 Ok I am running PS 1.7.7.6 and things may have been upgraded. But when an order has been paid by paypal 6 months ago. You are unable to do any Paypal refunds and order cancellation from BO/orders page. Manually, no problrm in refunding direct through Paypal. But there is no way you can change the PS order status to 'cancelled' Any ideas best way of doing it directly in mysql. Many thanks Link to comment Share on other sites More sharing options...

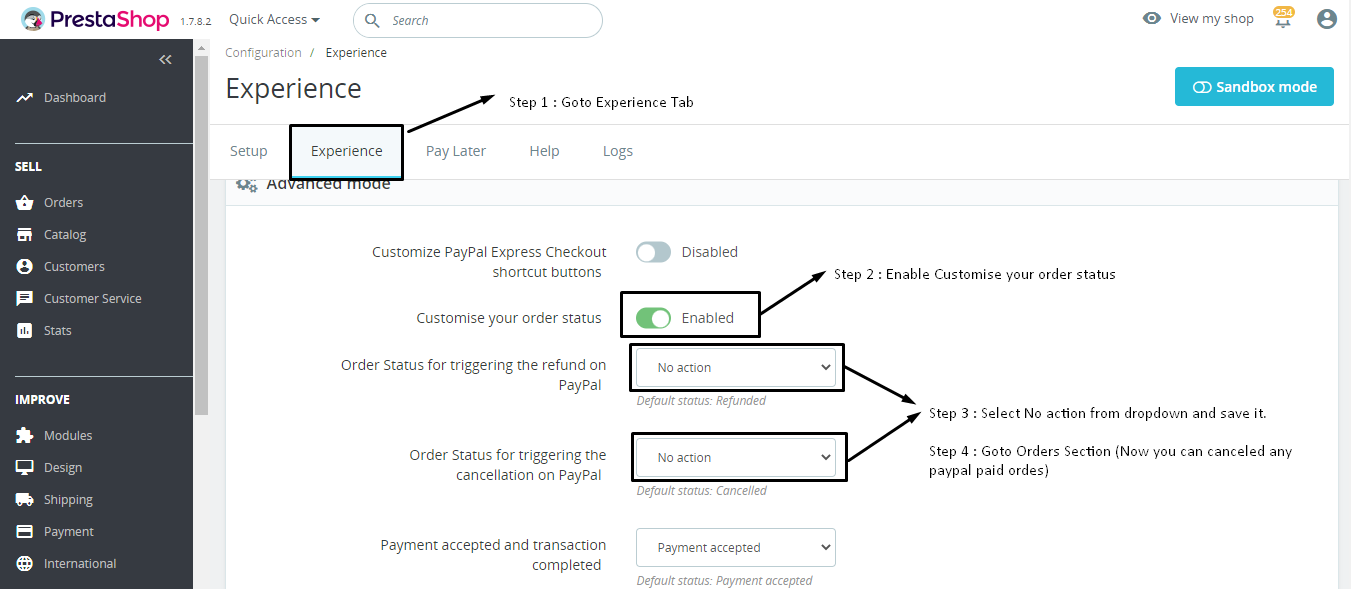

WebDesk Solution Posted February 21, 2023 Share Posted February 21, 2023 Hello @gray Suppose you don't want an automatic refund from PrestaShop, and you will manually manage the refund for that order from PayPal. In that case, you need to modify the PayPal payment module of PrestaShop. After that modification, you can cancel the order from Prestashop BO/Order directly. Please follow the following steps for the PayPal module modification process. Step 1: Goto Paypal payment module Step 2: Goto Experience Tab inside the Paypal Payment Module Then go to order section Link to comment Share on other sites More sharing options...
gray Posted February 23, 2023 Author Share Posted February 23, 2023 Hi - Thanks, but unfortuneatly that does not work for me. All Paypal settings cvhanged as above. When selecting 'refunded' it says 'the order should be refunded before the cancellation'. If I do not want Paypal to automatically refund, I need to change customer order status within paypal module, and select 'no action'. Which has been done. All I want is to change the PS order status to 'cancelled', maybe just within mysql Link to comment Share on other sites More sharing options...
WebDesk Solution Posted February 28, 2023 Share Posted February 28, 2023 Hello, Did you try to cancel the order from BO/order? Because as per our suggestions, changing the order status using MySQL is not the solution. Please share the recording/screenshots that will help us to guide you. Link to comment Share on other sites More sharing options...
gray Posted February 28, 2023 Author Share Posted February 28, 2023 Sorry I cannot give any screenshots (as its in the past on a live shop). PS1.7.7.6 Trying to explain. Had to refund customer, and tried through PS/admin order page via the 'refunded' on the order status pull down. But it threw an error, saying Paypal payment was to old, and no refund could be issued. So I went into Paypal and manually refunded customer. OK no problem. Went back into PS/admin order page and tried to 'canceled' on the order status pull down. But it threw an error that the order could not be cancelled, until it was refunded. This is where PS/admin order page does not accept the 'refunded, and you are in the vicous circle. Link to comment Share on other sites More sharing options...
WebDesk Solution Posted March 1, 2023 Share Posted March 1, 2023 Hello @gray If you applied the changes we mentioned for PayPal, then you can perform direct order cancellation from PS/BO/Order. Still, this does not work for you; you can change the order status to Refund and change it again to cancel. (Don’t worry. As per the settings we suggested, no order refund will be done through Paypal automatically) Link to comment Share on other sites More sharing options...
